The Real Cost of Membrane Bioreactors: From Module Replacement to Full-Plant TCO
2026-07-06 14:35
Favorite

1. Price Definition: What Is Actually Being Quoted?

MBR quotations are not directly comparable unless the supply boundary is normalized. A membrane-module price may exclude cassettes, aeration manifolds, permeate pumps, blowers, controls, clean-in-place equipment, fine screens and biological tanks. An equipment-package price may include startup but exclude installation. A full wastewater project can additionally include influent pumping, headworks, equalization, nutrient removal, UV disinfection, sludge handling, odor control, buildings, backup power, site development and outfall works.

Price level

Usually included

Usually excluded or variable

Best use

Membrane element/module

Membrane fibers or flat sheets, potting and module frame

Cassettes, manifolds, pumps, blowers, controls, tanks

Replacement and compatibility comparison

Membrane train / cassette package

Modules, cassettes, air headers, permeate connections

Biological process, civil tanks, headworks, installation

Retrofit or train expansion

MBR equipment package

Membranes, blowers, pumps, controls, instrumentation, manuals and startup

Civil works, electrical distribution, installation and site works may be excluded

Supplier bid comparison

Installed MBR process

Equipment, tanks, installation, electrical and commissioning

Upstream and downstream treatment may still vary

Process-level CAPEX comparison

Complete wastewater or reuse facility

Headworks, MBR, disinfection, sludge, buildings, site and utilities

Off-site pipelines, land, financing and owner costs may remain separate

Project financing and tariff analysis

Scope logic synthesized from public MBR procurement documents issued by the City of Duvall, Town of Woodstock and City of Anna, Texas.

1.1 Core System Configurations

Configuration

Typical economic profile

Main cost risks

Best-fit applications

Submerged hollow-fiber MBR

High packing density and broad municipal reference base

Fine screening, fiber integrity, air-scour energy, vendor-specific cassettes

Municipal reuse, large plants, constrained sites

Submerged flat-sheet MBR

Robust physical format and simplified visual inspection

Lower packing density, module handling and tank volume

Small-to-medium systems, variable wastewater

Sidestream / external MBR

High shear and accessible modules

Recirculation pumping and energy consumption

High-strength industrial wastewater and difficult solids

Containerized/package MBR

Fast deployment and factory integration

High unit CAPEX, transport, site interfaces and redundancy

Temporary capacity, remote sites, decentralized reuse

Anaerobic MBR / SAF-MBR

Potential energy recovery and low biosolids

Dissolved methane, sulfide, ammonia and scale-up risk

High-strength wastewater and future low-energy treatment

2. Public Cost Signals and Price Trend Evidence

The public record supports two different conclusions. First, membrane and package-equipment prices can be expressed on a capacity basis when scope is disclosed. Second, total project prices are highly sensitive to design maturity, inflation and site conditions, so project-estimate escalation should not be misread as membrane-module inflation.

Figure 1. Public MBR capacity-cost markers

Sources: US EPA, Membrane Bioreactors Wastewater Management Fact Sheet; City of Anna, Texas, 2023 temporary package MBR procurement proposal. The EPA range is historical and installed; the Anna figure is 2023 equipment procurement with delivery/startup but excludes installation. Values are not inflation-adjusted or directly interchangeable.

Interpretation. The Anna package proposal falls within the historical EPA order-of-magnitude range even though it excludes installation. This does not prove that MBR prices were flat over time. It shows that temporary modular capacity, redundancy, controls, delivery and startup can keep package-system pricing near the upper end of historical installed-cost indications.

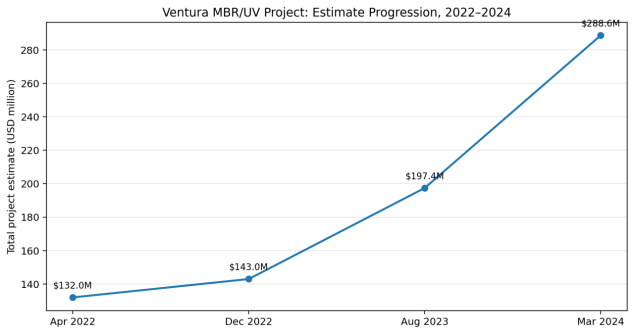

Figure 2. Ventura MBR/UV project estimate progression

Source: City of Ventura public presentation, 2024. Later estimates include demolition and a more mature understanding of backup power, odor control, stormwater, regulatory requirements and difficult site conditions. The figure is a project-development case study, not an MBR equipment price index.

2.1 Public Procurement and Budget Examples

Date / location

Public amount

Capacity / scope

What the figure demonstrates

2023, Anna, Texas

USD 8.3715 million

0.5 MGD temporary Kubota package MBR; procurement, fabrication, delivery and startup; installation excluded

Equipment-package cost can be high for modular and temporary capacity

2022 budget, Woodstock, Virginia

USD 2.2805 million

Membrane replacement and SCADA budget allocation

Replacement projects include controls and integration, not modules alone

2025 budget, Woodstock, Virginia

USD 2.9968 million

Multi-year membrane replacement and SCADA federal-fund allocation

Budget increased about 31% versus the 2022 allocation; not necessarily a like-for-like contract price

2022–2024, Ventura, California

USD 132 million to about USD 289 million

MBR/UV project estimate, with demolition added in later estimates

Inflation, design maturity, site and compliance can dominate total CAPEX

2023–2024, Maine public funding example

USD 48.23 million total project cost

MBR, disposal field and collection system

Full-project figures must not be compared with equipment-only bids

Sources: City of Anna public proposal; Town of Woodstock budgets and RFP; City of Ventura public presentation; Maine Department of Environmental Protection CWSRF project highlights.

2.2 Why a Global Historical Price Series Is Not Available

  • MBR designs vary by average flow, peak factor, flux, redundancy, wastewater strength, nutrient target and reuse standard.
  • Membrane area is not disclosed consistently, preventing reliable normalization to USD/m².
  • Public bids use different Incoterms and tax treatment and may include or exclude installation, electrical work and commissioning.
  • Municipal projects often combine MBR with UV, odor control, sludge processing, buildings and pipelines.
  • Vendor compatibility can create a concentrated replacement market even when new-build module competition is broad.

3. Product-Specific Cost Structure

The membrane itself is visible, but it is not the whole cost. At plant level, civil structures, biological aeration, membrane air scour, fine screening, pumps, controls, electrical infrastructure, redundancy and commissioning can equal or exceed the membrane package. The cost hierarchy changes with plant scale: small package plants carry more factory integration per unit of capacity, while large plants can achieve module and equipment scale but remain exposed to site and civil costs.

Cost block

Typical components

Cost direction

Key quotation questions

Membrane separation

Modules, cassettes, racks, manifolds, permeate headers

Driven by membrane area, flux, peak flow and redundancy

Guaranteed net flux? Standby train? Spare modules? Compatibility?

Biological process

Anoxic/aerobic tanks, mixers, internal recycle, process air

Driven by load, nutrient limits, temperature and SRT

Design loads? Oxygen-transfer basis? Winter performance?

Membrane aeration

Air-scour blowers, headers, diffusers and valves

Major OPEX and meaningful CAPEX

SADm/SADp guarantees? Turndown? Blower efficiency?

Pretreatment

1–3 mm screens, grit removal, grease and fiber control

Critical to module life and warranty

Screen opening, bypass protection and screenings handling?

Pumping and hydraulics

Permeate, backwash, recycle, waste sludge and feed pumps

Sensitive to head and control philosophy

Duty point, VFD control, N+1, energy guarantee?

Controls and instrumentation

PLC, HMI, TMP, turbidity, DO, flow and integrity monitoring

High integration and lifecycle value

Open protocols? Remote support? Cybersecurity? Data ownership?

Cleaning system

CIP tanks, chemical dosing, heating, transfer and neutralization

Depends on wastewater and fouling

Clean frequency, chemical limits and wastewater disposal?

Civil/electrical/site

Tanks, buildings, MCCs, generators, cabling, dewatering and foundations

Often the largest source of project volatility

Utility interfaces, geotechnical risk, backup power and code scope?

Startup and service

Commissioning, performance testing, training and long-term support

Can determine ramp-up and availability

Acceptance test, operator training, response time and spares?

3.1 Cost Drivers by Technical Parameter

Parameter

Lower-cost condition

Higher-cost condition

Economic mechanism

Average/peak flow ratio

Equalized flow and moderate peak factor

Peak flow 1.5–2.0× average without equalization

More membrane area and standby capacity

Net design flux

Validated conservative flux

Aggressive flux used to reduce initial module count

Lower CAPEX can increase fouling and replacement risk

Influent screening

Reliable 1–3 mm fine screening

Fibrous solids, hair and bypass events

Physical damage, ragging and warranty exposure

Nutrient limits

Secondary treatment only

Low TN/TP with reuse or sensitive discharge

More zones, recycles, chemicals and controls

Wastewater type

Municipal, stable and biodegradable

Industrial, oily, saline or toxic

Pilot testing, material upgrades and cleaning

Redundancy

Minimal standby equipment

N+1 trains, pumps and blowers

Higher CAPEX but greater availability

Site condition

Greenfield, good soil and simple utilities

Brownfield, groundwater, seismic or constrained site

Civil, demolition and construction sequencing

Delivery model

Local manufacture and standard package

Imported/custom system with local integration

Freight, duties, certification and service

4. Operating Cost and Energy Economics

Energy is the most transparent recurring cost lever. For submerged MBRs, biological aeration and membrane air scour normally dominate electrical demand. Low utilization can be especially damaging because some blowers, mixers and controls continue operating even when flow is below design.

Figure 3. Wastewater treatment energy benchmarks

Sources: California Energy Commission CEC-500-2024-044; Zuo et al., Membranes (2022); Kitanou et al., Desalination and Water Treatment (2021). Plant boundaries differ. The vibrating-MBR value is pilot-scale and should not be used as a guaranteed commercial benchmark.

Energy breakdown. A published domestic-wastewater MBR assessment attributed approximately 53% of electricity to biological aeration and about 25% to membrane filtration, with the balance associated with pumps and auxiliary systems. The exact split depends on oxygen demand, membrane configuration, air-scour strategy and hydraulic head.

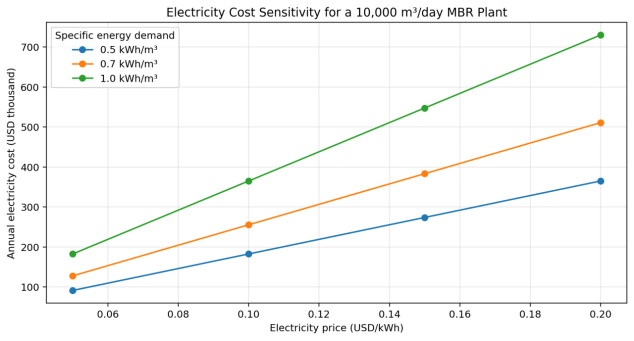

Figure 4. Electricity-cost sensitivity for a 10,000 m³/day MBR plant

Illustrative calculation: annual volume = 3.65 million m³; electricity cost = flow × specific energy demand × tariff. Excludes demand charges, power-factor penalties, backup generation and other OPEX.

Electricity price

0.5 kWh/m³

0.7 kWh/m³

1.0 kWh/m³

USD 0.05/kWh

USD 91,250/year

USD 127,750/year

USD 182,500/year

USD 0.10/kWh

USD 182,500/year

USD 255,500/year

USD 365,000/year

USD 0.15/kWh

USD 273,750/year

USD 383,250/year

USD 547,500/year

USD 0.20/kWh

USD 365,000/year

USD 511,000/year

USD 730,000/year

Illustrative annual-energy model for a constant 10,000 m³/day flow. Actual plants have seasonal flows, demand charges and non-MBR loads.

4.1 Other OPEX Components

OPEX item

Primary driver

Typical failure in low-price comparisons

Buyer control

Membrane cleaning chemicals

Fouling, CIP frequency and chemical compatibility

Assuming vendor laboratory frequency at full-scale wastewater conditions

Pilot data, cleaning log guarantee and chemical consumption cap

Membrane replacement reserve

Module price, life and prorated warranty

Ignoring replacement until failure

Annual reserve and contractually defined life test

Sludge treatment and disposal

SRT, yield, dewatering and local gate fee

Comparing only liquid-line power

Mass-balance guarantee and disposal-cost model

Labor

Automation, operator skill and regulatory sampling

Assuming package plant means unattended operation

Staffing plan, remote support and alarm philosophy

Maintenance and spares

Blowers, pumps, valves, instruments and proprietary parts

Pricing only membrane spares

Five-year spare-parts schedule and lead-time commitment

Downtime and bypass

Redundancy, cleaning sequence and repair response

Treating availability as non-financial

Availability guarantee, N+1 design and liquidated damages

5. Membrane Life, Warranty and Replacement Economics

Membrane life is the key bridge between purchase price and TCO. The EPA identifies membrane life as central to cost-effectiveness and notes that municipal guarantees have ranged from three to five years, with some ten-year guarantees. A 2023 Woodstock replacement RFP stated that the original membranes installed in 2010 had an expected life of about ten years, demonstrating that procurement decisions made at initial construction can affect replacement economics more than a decade later.

Figure 5. Annual membrane replacement reserve

Illustrative straight-line reserve expressed as a percentage of the next replacement purchase cost. It excludes discounting, escalation, salvage value and prorated warranty recovery.

Membrane life

Annual reserve

Procurement implication

3 years

33.3% of replacement cost/year

High-cost outcome; often indicates difficult wastewater, damage, aggressive flux or weak warranty

5 years

20.0%/year

Common minimum planning case for industrial or uncertain service

7 years

14.3%/year

Balanced municipal planning assumption where pretreatment and cleaning are controlled

10 years

10.0%/year

Strong lifecycle outcome, but warranty conditions and actual integrity must be verified



5.1 Warranty Clauses That Change Economic Value

  • Full replacement versus prorated reimbursement after a defined operating period.
  • Guaranteed membrane area, permeability, integrity and maximum transmembrane pressure.
  • Required screen opening and exclusions for grease, fibers, hydrocarbons or chemical overexposure.
  • Limits on chlorine concentration, cumulative exposure, pH and cleaning temperature.
  • Definition of failure: individual fiber repair, module replacement, cassette replacement or loss of guaranteed capacity.
  • Freight, field labor, crane/handling and process downtime during warranty replacement.
  • Compatibility with existing cassettes, PLC logic, air headers and permeate connections.

5.2 Total Cost of Ownership Model

Recommended TCO boundary: equipment purchase + freight/duties + installation + civil/electrical interfaces + commissioning + energy + chemicals + labor + sludge handling + planned maintenance + membrane reserve + critical spares + downtime risk − land and downstream filtration savings − reuse-water value.

Economic variable

Required input

Why it matters

Design and average flow

m³/day and utilization profile

Fixed loads make low utilization expensive

Specific energy demand

kWh/m³ at average and peak conditions

Directly links design to tariff exposure

Electricity tariff

Energy, demand and power-factor charges

Regional differences can reverse supplier ranking

Membrane replacement

Price, life, warranty and labor

Creates periodic cash outflows and downtime

Chemical usage

kg or L per m³ and clean frequency

Industrial wastewater can deviate sharply from municipal assumptions

Sludge production

kg dry solids per m³ and disposal fee

Long SRT may reduce yield but does not eliminate solids cost

Availability

Guaranteed online capacity and repair time

Lost production or non-compliance can exceed maintenance cost

Reuse value

Avoided freshwater and discharge cost

Can justify MBR premium in water-scarce or industrial sites

Land and civil savings

Avoided clarifiers/filters and footprint value

Critical in brownfield and high-land-cost locations

6. Regional Cost and Procurement Differences

Region

Cost position

Key delivered-cost drivers

Procurement emphasis

North America

High installed CAPEX and labor; transparent public procurement

Civil works, electrical codes, backup power, union labor, site constraints and long lead equipment

Performance guarantees, local service, public-bid scope and lifecycle documentation

Europe

High energy and compliance value; strong focus on resource efficiency

Electricity price, nutrient/micropollutant requirements, energy audits and carbon objectives

Energy guarantee, automation, upgradeability and circular-economy integration

China

Competitive module and standard equipment manufacturing

Quality tier, project references, material specification, export certification and overseas service

Factory audit, module traceability, third-party testing and spare-parts plan

India and Southeast Asia

Strong price sensitivity with growing reuse demand

Power quality, variable influent, operator capability, imported components and local fabrication

Simple operation, robust pretreatment, remote support and tariff sensitivity

Middle East

Water-reuse value can support higher-spec systems

High temperature, salinity, industrial variability, chemical supply and service response

Materials, cooling/ventilation, reuse standard and local O&M capability

Latin America

Project economics strongly financing-dependent

Currency, import duty, local civil cost, utility power and municipal credit

Local assembly, payment protection, training and phased capacity

Africa and remote markets

Package systems may dominate but unit CAPEX is high

Freight, power reliability, chemicals, operator availability and long spare lead times

Modularity, low-energy mode, critical spares and local partner capability

6.1 Trade and Landed-Cost Checklist

Cost layer

Questions to resolve before comparing offers

Ex works / FOB

Are modules, cassettes, air headers, pumps, blowers, PLC, instruments, CIP and spares included?

Freight and insurance

Container count, oversize loads, storage requirements, hazardous cleaning chemicals and insurance basis?

Tariffs and taxes

HS classification, import duty, VAT/GST, exemptions and local-content rules?

Certification

Electrical standards, pressure vessels, seismic design, material certificates, cybersecurity and grid requirements?

Installation

Who supplies tanks, cranes, piping, cabling, MCC/VFDs, foundations and temporary treatment?

Commissioning

Duration, wastewater availability, performance-test protocol, operator training and retesting cost?

Service

Local technician location, response time, remote access, language, stock and annual support fee?

Currency/payment

Exchange-rate adjustment, advance payment, letters of credit, retention and performance security?

7. Price and Cost Outlook, 2026–2028

Base-case judgement. MBR module pricing should remain competitive where multiple suppliers can meet a standard new-build specification. However, installed project cost is unlikely to follow the same downward trajectory because labor, civil works, electrical infrastructure, regulatory requirements and site conditions remain difficult to standardize.

Driver

2026–2028 direction

Expected effect

Standard membrane modules

Competitive / mixed

Scale and supplier competition pressure price, while warranty and material quality preserve premium tiers

Proprietary replacement modules

Firm

Installed-base compatibility and process risk reduce buyer leverage

Blowers, pumps and controls

Stable to upward in nominal terms

Efficiency, instrumentation and cybersecurity increase specification content

Civil and electrical works

Volatile

Local labor, site constraints, backup power and permitting remain project-specific

Energy-efficient operation

Increasing value

EU energy-neutrality policy and high industrial tariffs strengthen lifecycle focus

Package and temporary systems

Premium over permanent standardized capacity

Factory integration, rapid delivery and modular redundancy raise unit cost

Anaerobic and low-aeration MBR

Technology progress, limited broad benchmarkability

Potential OPEX improvement but process and scale-up risk remain

Water-reuse value

Increasing strategic importance

Avoided freshwater, discharge and drought risk can outweigh equipment-price differences

7.1 Three Procurement Scenarios

Scenario

Selection logic

Likely result

Lowest initial price

Minimum membrane and equipment scope; limited redundancy and service

Lowest bid price but highest risk of change orders, energy underperformance and replacement cost

Balanced lifecycle case

Validated flux, efficient aeration, N+1 critical equipment, clear warranty and local service

Moderate CAPEX with more predictable OPEX and availability

High-reliability reuse case

Conservative flux, advanced monitoring, robust pretreatment, full redundancy and long-term service

Highest CAPEX, but strongest compliance, reuse-water quality and financing acceptance

8. Procurement Recommendations

8.1 Mandatory Bid Normalization

  • Normalize every quotation to average and peak design flow, net membrane area, guaranteed flux, recovery, redundancy and treatment standard.
  • Create separate price columns for membrane modules, cassettes, balance of equipment, installation, civil/electrical works, commissioning, freight, duties and taxes.
  • Require energy guarantees at average-day flow, peak-day flow and minimum turndown—not only at design flow.
  • Request a five- or ten-year membrane-replacement schedule with module price assumptions, prorated warranty and field labor.
  • Compare delivered cost under the same Incoterm and clearly state whether storage, insurance and inland transport are included.

8.2 Technical and Commercial Evaluation Matrix

Evaluation item

Minimum evidence

Commercial consequence if absent

Reference plants

Comparable flow, wastewater, effluent standard and operating years

Higher process and scale-up contingency

Flux and peak capacity

Guaranteed net flux table by temperature and operating mode

Hidden membrane-area shortfall or excessive fouling

Energy guarantee

Connected load and measured kWh/m³ boundary

OPEX uncertainty and weak performance enforcement

Membrane life

Warranty, integrity criteria, repair limits and replacement pricing

Unfunded lifecycle liability

Pretreatment

Screen specification, bypass protection and grease/fiber limits

Physical damage and warranty disputes

Automation

Control narrative, remote support, open protocol and cybersecurity

Integration cost and vendor lock-in

Spares and service

Five-year list, lead times, local inventory and technician response

Long downtime and emergency freight

Performance testing

Influent range, duration, sampling, pass/fail criteria and retest

Ambiguous acceptance and payment disputes

Financial strength

Audited accounts, bonds, insurance and project history

Completion and warranty risk

Scope exclusions

Signed deviation and responsibility matrix

Change orders and schedule claims

8.3 Risk Matrix

Risk

Probability

Impact

Mitigation

Influent differs from design basis

Medium–High

High

Sampling campaign, load envelope and pilot testing

Membrane fouling or damage

Medium

High

Fine screening, conservative flux, cleaning protocol and warranty

Energy guarantee not met

Medium

High

Metered acceptance test at defined plant boundary

Proprietary replacement lock-in

High

Medium–High

Price formula, compatibility rights and long-term supply agreement

Civil/site escalation

High

High

Geotechnical work, design maturity and realistic contingency

Controls integration delay

Medium

Medium–High

Interface matrix, FAT/SAT and open protocols

Local service unavailable

Medium

High

Response-time SLA, training and critical-spares stock

Currency/tariff movement

Medium

Medium

Hedging, local content and contract adjustment formula

Reuse standard changes

Low–Medium

High

Upgrade space, flexible controls and downstream treatment allowance

9. Conclusion

The central purchasing mistake is to treat MBR as a membrane commodity. Membrane modules are only one layer of a process whose economics depend on aeration, utilization, pretreatment, redundancy, controls, civil works and long-term service. Public procurements show that package capacity can command a substantial premium, while public project estimates show that site and compliance costs can overwhelm any reduction in module price.

For 2026–2028, the most likely competitive shift is not a universal fall in MBR price, but a wider separation between low-cost equipment offers and bankable lifecycle solutions. Suppliers that can demonstrate low measured energy use, long membrane life, open controls, strong local service and clear scope will retain pricing power. Buyers should award on normalized delivered cost and treatment value rather than the lowest membrane or package quotation.

Industrial judgement: MBR is economically strongest where land is constrained, effluent standards are stringent, or reuse water has measurable value. It is economically weakest where power is expensive, utilization is low, pretreatment is poor and replacement modules are purchased without long-term price or warranty protection.
