Energy Storage Systems to 2030: Regional Demand, Technology Competition and Value-Chain Opportunities
2026-06-30 10:57
Favorite

1. Global Market Scale and Growth Stage

Public market-revenue estimates differ because some datasets count battery packs only, while others include power conversion systems (PCS), energy management software, containers, civil works, engineering, procurement and construction (EPC), development fees, or long-term service. Capacity additions and installed-cost data are therefore more reliable for cross-market trend analysis than a single global revenue figure.

Figure 1. Global Battery Storage Capacity Additions

Source: IEA, Batteries and Secure Energy Transitions (2024) and Global Energy Review 2026. 2024 is an implied value based on the reported 2025 growth rate.

The 2025 addition of 108 GW was roughly eleven times the annual deployment level implied by 2021, according to the IEA. Growth is being driven by solar and wind integration, peak shifting, capacity adequacy, transmission congestion, frequency response, resilience requirements and increasingly by data-center and industrial-power demand. The next phase will involve both short-duration batteries and a broader portfolio of long-duration storage, flexible demand, grid expansion and dispatchable generation.

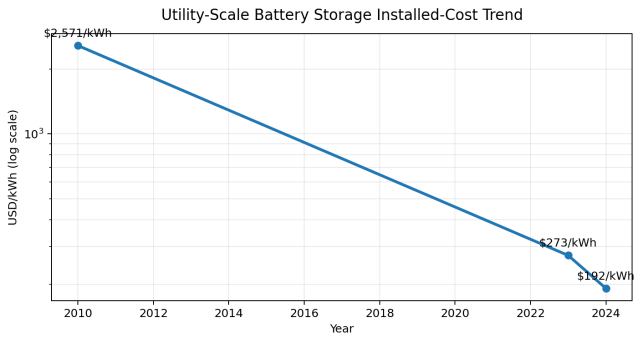

Figure 2. Utility-Scale Battery Storage Installed-Cost Trend

Source: IRENA, Renewable Power Generation Costs in 2024; IRENA World Energy Transitions Outlook 2024.

Metric

Latest verified signal

Interpretation

Global battery additions

108 GW in 2025

Approximately 40% above 2024; fastest-growing power technology.

Dominant chemistry

LFP ~90% of 2025 deployments

Stationary systems prioritize cost, life and safety over maximum energy density.

Utility-scale installed cost

USD 192/kWh in 2024

Global benchmark; not a turnkey quote for every market or duration.

2030 system requirement

Global storage capacity more than sixfold versus 2023 in the IEA pathway

Batteries supply about 90% of incremental storage; pumped hydro provides most of the remainder.

U.S. additions

15 GW in 2025; 24 GW planned for 2026

Pipeline remains large, but planned capacity is subject to delay or cancellation.

2. Regional Market Structure

Figure 3. Near-Term Regional Market Attractiveness

Source: Analytical index based on deployment momentum, policy support, grid need, bankability and entry barriers; not a market-share forecast.

Region

Market character

Primary opportunity

Principal entry constraint

China

Largest manufacturing base and rapid domestic deployment

Utility-scale renewable integration, shared storage, C&I systems

Severe price competition and qualification requirements

United States

Fast growth in ERCOT, CAISO and other markets

Merchant and contracted utility-scale BESS; solar-plus-storage

Interconnection queues, changing trade policy, local codes

Europe

Fragmented but deep flexibility market

Balancing, capacity, congestion relief, C&I optimization

Country-specific market design and permitting

Australia

High-renewables, mature big-battery market

Grid-forming systems, energy shifting and ancillary services

Revenue cannibalization and connection studies

India

Large renewable and peak-demand need

Tenders for standalone and renewable-hybrid storage

Aggressive tariffs, payment risk and localization

Middle East

Rapid solar expansion and state-backed procurement

Large solar-plus-storage and isolated-grid projects

Tender concentration and bankability requirements

Latin America

Growing renewable curtailment and resilience need

Chile, Brazil, Mexico and islanded systems

FX, financing and regulatory uncertainty

Africa

High need but uneven project bankability

Mini-grids, mines, telecom, C&I and island systems

Financing, service coverage and weak grids

China sets the global equipment cost curve through cell, PCS and system-integration scale. The United States is a major profit pool because storage can participate in energy, capacity and ancillary-service markets, although project economics vary by region. Europe has strong demand for balancing and flexibility but remains highly fragmented. Australia is an important reference market for large batteries, grid-forming controls and high renewable penetration. Emerging markets often show strong technical need, but financing and contract design are the decisive filters.

Figure 4. United States Utility-Scale Battery Storage Additions

Source: U.S. Energy Information Administration. 2024 and 2025 are reported additions; 2026 is developer-planned capacity as of February 2026.

3. Technology Roadmap and Product Evolution

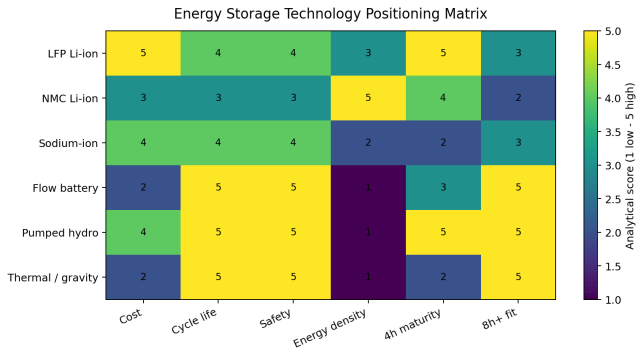

Figure 5. Energy Storage Technology Positioning Matrix

Source: Author analysis using public technical characteristics. Scores are comparative and illustrative, not test results.

Technology

Typical duration

Commercial position

Best-fit applications

Key limitation

LFP lithium-ion

1-6 hours

Global default for new BESS

Frequency response, peak shifting, solar firming, C&I

Thermal-event management and degradation

NMC lithium-ion

1-4 hours

Mature but losing stationary share

Space-constrained or high-energy-density systems

Higher cost and more demanding thermal safety

Sodium-ion

2-6 hours

Early commercial scale-up

Cost-sensitive stationary systems, cold climates

Lower energy density and limited bankability history

Flow batteries

4-12+ hours

Commercial niche / scaling

High-cycle long-duration systems

Higher upfront cost and larger footprint

Pumped-storage hydro

6-20+ hours

Mature, dominant installed capacity

Bulk storage and system adequacy

Long development time and site dependence

Thermal, gravity, compressed air

4 hours to multi-day

Technology-specific demonstrations and early projects

Industrial heat, long-duration and capacity applications

Project-specific efficiency and limited reference base

LFP has become the standard chemistry because stationary storage values usable lifetime, safety and cost more than vehicle-grade energy density. Future product evolution will include higher-voltage architectures, larger container blocks, liquid cooling, improved propagation resistance, grid-forming inverters, direct-to-DC architectures, artificial-intelligence-assisted diagnostics and more sophisticated state-of-health estimation. Larger blocks can reduce balance-of-plant cost, but may increase concentration of failure risk and complicate fire separation and maintenance.

4. Cost, Pricing and Project Economics

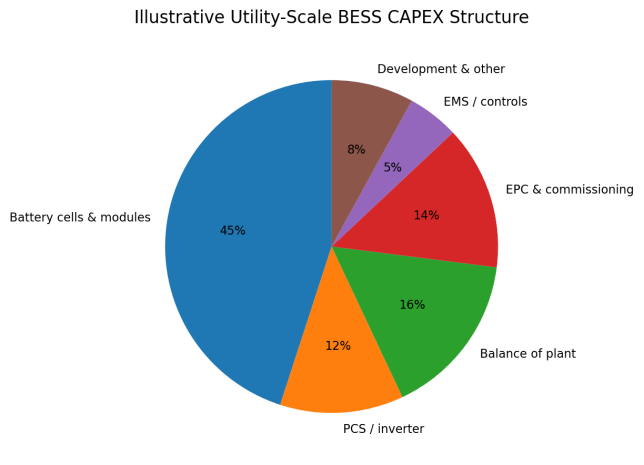

Figure 6. Illustrative Utility-Scale BESS CAPEX Structure

Source: Illustrative synthesis for a containerized lithium-ion project. Actual shares vary by duration, location, grid scope, tariff and contracting model.

A storage quotation should state whether pricing is ex-works, free on board (FOB), cost-insurance-freight (CIF), delivered-duty-paid (DDP), equipment-only, installed or turnkey EPC. Buyers should also distinguish nominal energy from usable energy at the point of interconnection and should normalize bids for duration, depth of discharge, efficiency, degradation, augmentation and end-of-life capacity.

Cost driver

Direction

Why it matters

Battery cells

Generally downward but volatile

Largest equipment cost; sensitive to lithium, phosphate, graphite, utilization and trade measures.

PCS and transformers

Moderating with scale

Grid-code, voltage and grid-forming requirements can add premiums.

Civil and electrical balance of plant

Location-specific

Soil, drainage, fire setbacks, substation and cable runs create large project variance.

Interconnection

Often upward / uncertain

Network upgrades and delay costs can dominate development economics.

Financing

Highly market-specific

Interest rates, merchant exposure and warranty bankability affect weighted average cost of capital.

Operations and augmentation

Underestimated in low bids

Capacity retention may require replacement modules, HVAC maintenance and software support.

Levelized cost of storage (LCOS) is useful only when assumptions are explicit. Results change materially with cycle frequency, charging cost, round-trip efficiency, degradation, residual value, discount rate and revenue stacking. A four-hour battery used daily has a different economic profile from a reserve asset cycled only occasionally. Procurement should therefore evaluate a defined dispatch profile rather than rely on a generic LCOS number.

5. Value Chain and Supply Structure

The value chain includes critical minerals, active materials, cells, modules and racks, thermal management, battery management systems, PCS, transformers, switchgear, containers, fire detection and suppression, energy management software, project development, EPC, financing, market optimization and long-term service. Cell manufacturing remains concentrated in Asia, especially China. This creates cost advantages but also exposes projects to tariffs, shipping rules, local-content requirements and evolving cybersecurity or supply-chain restrictions.

Value-chain segment

Current pressure

Where premium remains

Cells and standard containers

Commoditization and overcapacity

Traceability, safety validation, cycle life and warranty strength

PCS / inverter

Price competition

Grid-forming capability, weak-grid performance and local grid-code certification

System integration

Margin compression

Validated system architecture, controls, commissioning and availability guarantees

Software / optimization

Growing strategic value

Forecasting, dispatch, market bidding, cybersecurity and multi-asset control

EPC and grid connection

Bottleneck in many markets

Permitting, utility relationships, construction execution and risk allocation

Long-term service

Increasing value

Local spares, augmentation planning, response times and balance-sheet support

6. Competitive Landscape

Competition spans battery manufacturers, vertically integrated system suppliers, independent integrators, inverter companies, EPC contractors and software optimizers. Chinese suppliers compete strongly on manufacturing scale and price. North American and European firms often emphasize market integration, local compliance, optimization software and bankability. The boundary between supplier categories is becoming less distinct as cell makers offer complete AC or DC blocks and inverter manufacturers move into integrated solutions.

Supplier ranking should not rely on shipment volume alone. A bankable shortlist should test operating references in the target climate and grid, audited safety evidence, warranty reserves, response capability, software ownership, cybersecurity governance, local spare parts, augmentation commitments and the financial capacity to honor a 15- to 20-year service obligation.

7. International Market Entry and Export Opportunities

Entry route

Best suited to

Advantages

Risks

Direct equipment export

Standardized C&I and utility blocks in import-friendly markets

Fast market entry and low fixed cost

Weak local service and importer dependence

Local distributor / service partner

Fragmented C&I and residential markets

Customer access and local-language support

Channel conflict and uneven technical capability

EPC or developer partnership

Utility-scale tenders and solar-plus-storage

Project references and shared delivery risk

Lower margin and dependence on partner pipeline

Local assembly / integration

Markets with tariffs or local-content rules

Improved eligibility and service response

Working-capital and quality-control burden

Joint venture

Strategic state-led markets

Local credibility, licenses and financing access

Governance, IP and partner-alignment risk

Software / controls specialization

Markets with commoditized hardware

Higher recurring-value potential

Requires proven interoperability and cyber compliance

Exportable opportunities are strongest in standardized container systems, PCS, thermal management, fire safety components, battery management and energy management software, prefabricated substations, testing services, maintenance, repowering and augmentation. Direct equipment export is viable where standards are harmonized and local-content rules are limited. Local assembly, EPC partnership or service centers are more important in the United States, India, parts of Europe and state-led Middle Eastern procurement.

8. Procurement and Project Implications

  • Define rated power, nominal energy, usable energy, point-of-interconnection capacity and duration separately.
  • Compare guaranteed round-trip efficiency at the actual operating point, including HVAC and auxiliary loads.
  • Require a degradation and augmentation schedule tied to the intended dispatch profile and ambient conditions.
  • Specify availability, response time, ramp rate, reactive power and grid-forming obligations with test procedures.
  • Review cell, rack, container and plant-level safety evidence, emergency response planning and local fire-code compliance.
  • Test warranty exclusions for cycling, temperature, state of charge, downtime, software updates and third-party dispatch.
  • Evaluate the supplier and guarantor balance sheet, not only the project special-purpose company.
  • Clarify responsibility for grid studies, harmonic compliance, commissioning, performance testing and liquidated damages.
  • Require cybersecurity controls, data ownership, remote-access governance and software-support commitments.
  • Calculate lifecycle cost under downside cases for delayed interconnection, lower spreads and earlier augmentation.

9. Principal Risks and Mitigation

Figure 7. Battery Energy Storage Project Risk Matrix

Source: Author assessment for a typical utility-scale project; project-specific due diligence is required.

Risk

Potential consequence

Mitigation

Thermal event / fire

Asset loss, shutdown, permitting delay and reputational damage

Propagation testing, separation, detection, ventilation, emergency plans and insurer review

Grid-connection delay

Lost revenue and financing carry

Early studies, milestone rights, upgrade caps and delay contingencies

Revenue compression

Lower merchant returns

Conservative forecasts, contracted floors and multi-market capability

Degradation underperformance

Reduced usable energy and early augmentation

Dispatch-linked warranty, independent model review and performance tests

Trade and localization changes

Higher cost or ineligible equipment

Dual sourcing, customs review, origin traceability and local assembly options

Supplier distress

Unsupported equipment and warranty loss

Parent guarantees, escrow, step-in rights and spare-parts strategy

Cybersecurity breach

Operational disruption or market manipulation

Network segmentation, access controls, patch policy, logs and incident response

10. Conclusion and Outlook

The global energy storage system market will continue to expand rapidly, but growth quality is changing. Hardware prices are falling and standard lithium-ion blocks are becoming more commoditized. The value pool is shifting toward grid access, controls, optimization, safety engineering, project execution, financing and long-term service. Markets with high renewable penetration and functioning flexibility mechanisms will remain the most attractive, while emerging markets will require stronger guarantees and financing structures to convert technical demand into bankable projects.

LFP will retain the dominant position in short- and medium-duration battery storage through the near term. However, the requirement for eight-hour, multi-day and seasonal flexibility will create a portfolio market rather than a single-technology market. Successful suppliers will combine competitive equipment with certified safety, grid-code capability, transparent degradation guarantees, local service and credible balance-sheet support. Successful buyers will procure lifecycle performance and dispatch capability, not simply the lowest equipment price per kilowatt-hour.
